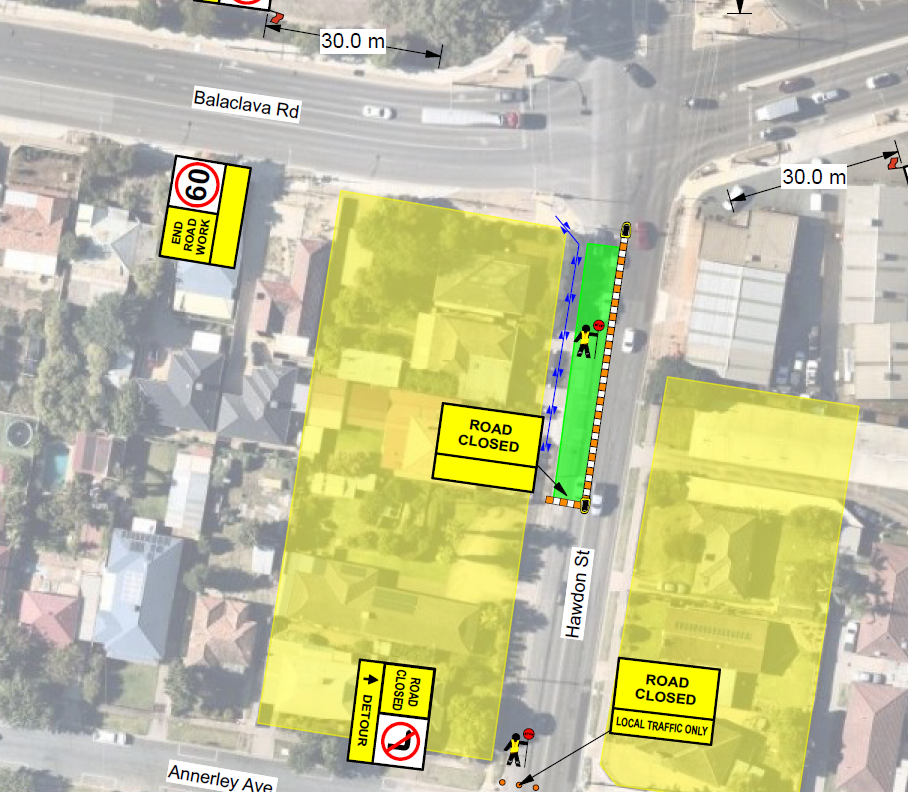

Works are now complete on the second stage of the Hawdon St water main replacement project, with another 300m of new water main successfully installed.
The new 180mm main was installed between Rea St and Balaclava Rd, with about 30 customers connected in for a more reliable service.
The remaining section of water main construction and relining of the existing main to continue supplying high-volume customers will be carried out in over the Easter school holidays.
GVW thanks motorists for their patience while these important upgrades are carried out.
Works are continuing to progress well in the second of three phases to replace the ageing water main along Hawdon St. We've installed several new sections of pipe between Rea St and Balaclava Rd, as well as carrying out pressure testing.
Works will continue next week and into the week after to finalise this section of the project - we anticipate this wrapping up on Friday, February 10.
With school resuming on Monday, works will only be occurring between 9:30am and 2.30pm to lessen any impact on the traffic during peak periods.
We're really sorry for any inconvenience - we thank residents along Hawdon St for their patience while we complete this important upgrade.
The second stage of major works to replace an ageing water main along Shepparton’s Hawdon St will begin in January.
Contractors will begin onsite from Tuesday, January 3, 2023 and will focus on the water main located between Rea St and Balaclava Rd.
Works are expected to take about three weeks, and have been scheduled during the holidays to complete the majority of construction before school resumes and to lessen the impact on motorists using Hawdon St.
To reduce construction time, two crews will work simultaneously to install a new 180mm HDPE water main and connect customers to the new, more reliable service.
The existing 375mm-diameter main will also be lined with a new HDPE insert and will continue to supply other high-volume water users on the line.
GVW thanks motorists for thier patience if they experience any delays during the construction phase - customers along Hawdon St will up kept update via SMS and on this page.
Businesses along Hawdon St will remain open during the works.
The first stage of the major water main replacement project along Hawdon St is now complete.
Goulburn Valley Water is thanking residents along Hawdon St and motorists for their patience and understanding during construction, and the resulting slight traffic delays.
About 300m of a new 180mm water main was installed along Hawdon St between Knight and Rea Sts; with the majority of works carried out during school holidays to minimise the impact on road users.
The remaining section of water main construction and relining of the existing main to continue supplying high-volume customers will be carried out in early and mid-2023.
GVW Managing Director Steve Capewell said the first phase of the project had been successful; and while intense rainfalls had occurred during the works, there was no major impact and works were still complete within the original timeframe.
“We saw around 30 customers connected to a new water main that will improve their service reliability for the next 50 years,” he said.
“We’d like to thank people for their patience while we carried out this important infrastructure upgrade.”
Overall, the project will see about 800m of water main replaced along Hawdon St between Knight St and Balaclava Rd to improve service reliability, following a number of bursts and leaks during the past couple of years.
GVW will keep customers informed ahead of the beginning of the second phase of works, expected to begin in January.
Works underway along Hawdon St in late September.
Works are continuing to progress well in the first of three phases to replace the ageing water main along Hawdon St. We've installed several new sections of pipe between Knight and Thames Sts, as well as carrying out pressure testing.
Works will continue next week and into the week after to finalise this section of the project - we anticipate this wrapping up on Friday, October 14.
With school resuming on Monday, works will only be occuring between 9am and 2.30pm to lessen any impact on the traffic during peak periods.
We're really sorry for any inconvenience - we thank residents along Hawdon St for thier patience while we complete this important upgrade.
First phase of works underway
Our contractors Veolia are currently on site, preparing for works to start on Monday as the first major phase of the Hawdon St water main replacement project begins.
Works will be carried out between 7am and 5pm, Monday to Friday. Some sections of the road will be closed, but two-way traffic will remain in place at all times. Motorists using Hawdon St should expect some delays, but we’ll work to minimise the impact on traffic as much as possible, and traffic management will be in place.
The majority of works are expected to be completed within the two-week school holiday period, but we may need to continue works into the first two weeks of October. If that’s the case, we’ll limit works between 9.30am and 2.30pm to avoid impact on school bus services.
In this stage of works, we’ll be installing a new 180mm diameter ‘rider’ water main alongside the existing main.
Two crews will be working simultaneously – one installing a 173m section near the Knight St intersection and one a 224m section near Rea St.
There will be no impact to customers’ water supply during this stage of the upgrade.
Businesses remain open during the upgrades.
Works for the first phase will begin from September 14 along a section of Hawdon St between Knight and Rea Sts. The majority of the works are expected to be completed by early October as school resumes.
The second and third phases will occur in January and April.
Motorists using Hawdon St are encouraged to plan their journeys and allow extra travel time for potential short delays; traffic management will also be in place.
The replacement would improve service reliability after the existing water main experienced several failures in the past year and was now at the end of its useful life.
Hawdon St residents will be kept informed of key developments via SMS, along with updates on this webpage.
Businesses along Hawdon St will remain open during the works.
Motorists may experience temporary delays along Shepparton’s Hawdon St next week as Goulburn Valley Water begins exploratory works for a future water main replacement project.
Small sections of the main will be drilled into along Hawdon St between Knight St and Balaclava Rd, to help understand the existing main’s condition and to determine the right replacement option.
Works will begin on Tuesday, 28 June and are expected to run for two to three days.
Crews will only be working on small sections of the road at a time to minimise the impact on road users and traffic management will be in place.
There will be no interruption to the water supply during these works.
